Boulder Creek Renovation

Significant renovations to the Boulder Creek building to create a single facility to house the Community College of Denver’s (CCD) Health Sciences programs. The existing building will be fully renovated, and a new 9,484-square-foot addition will be constructed on the southeast side of the building. This project will house the departments of Dental Hygiene, Health and Wellness, Nursing, Phlebotomy/ Medical Assisting, Radiologic Tech, Surgical Tech, and Vet Tech.

  • Location: Boulder Creek Building
  • Estimated Budget: $30 million
  • Funding Source: Combination of State of Colorado funding and CCD funding
  • Anticipated Timeframe: June 2025 – Dec. 2026

CAMPUS SAFETY CENTER

New 32,000 square foot facility to house the Auraria Campus Police Department, Criminal Justice program classrooms and labs, and a 24/7 campus community space including study areas and student lounges.

  • Location: Corner of Curtis & 7th Street
  • Estimated Budget: $36 million
  • Funding Source: State of Colorado Capital Construction funds
  • Anticipated Timeframe: April 2026 – May 2027

CAMPUS Wide Access Control & Security Upgrade

Updating campus access and security systems to one consolidated platform that is easier to maintain and monitor. This project includes acquiring a new access control software system, modernizing wiring to support new system, adding card readers on all classrooms and labs, updating panic buttons to new consolidated platform, and updating intrusion systems on high security spaces to new consolidated platform.

  • Location: Campus Wide – All Buildings 
  • Estimated Budget: $11.5 million
  • Funding Source: State of Colorado Controlled Maintenance project 
  • Anticipated Timeframe: November 2026 – December 2029

Events Center Pool Renovation

MSU Denver is reimagining part of the Auraria Campus Event Center to better support student and community events. This renovation will transform the former aquatic facility into a flexible, dividable event space with seating for up to 500 people.

  • Locations: Events Center
  • Estimated Budget: $11 million
  • Funding Source: TBA
  • Anticipated Timeframe: Dec. 2026 – July 2027

Golda Meir Fence and Landscape Improvements

Through generous donations, the Golda Meir house will be undergoing important site improvements including adding a secure fence, updating irrigation, building a new memorial garden along, and improving the exterior gathering space in the back of the building.

  • Location: Golda Meir House
  • Estimated Budget: $500,000
  • Funding Source: Rose Family Foundation and Donations
  • Anticipated Timeframe: May 2026 – Oct. 2026

Merage Early Learning Center & Workforce Housing

This newly constructed building will be a 7-story, 25,000 square-foot building with both affordable and market rate apartments. This offers a great option for campus community members to live close to where they work and go to school. The building will also include a new state of the art location for Auraria Campus’ Early Learning Center.

  • Location: Lot East of the Tivoli Garage
  • Estimated Budget: TBD
  • Funding Source: Combination of private developer funds, grants, capital campaign/philanthropic dollars, upfront ground lease dollars and debt financing
  • Anticipated Timeframe: Summer 2026 – Early 2028

MSU Denver Gina and Frank Day Health Institute Tower

MSU Denver is constructing a new 70,000 square foot tower addition to the West Classroom Building. The building will house the majority of the Gina and Frank Day Health Institute program including 10 health-related academic departments that are training students for careers in nursing, nutrition, behavioral health, speech-language pathology, exercise science, social work, and more.

  • Location: South end of the West Classroom building at Champa & 10th Street
  • Estimated Budget: $65 million
  • Funding Source: State of Colorado funding, grants, and donations
  • Anticipated Timeframe: Nov. 2025 – May 2027

Peace and Healing Garden

Through ongoing collaboration between the Auraria Historical Advocacy Council, Displaced Aurarians & their descendants, and staff from Auraria Campus, CCD, MSU Denver, & CU Denver, an approximately 7,000 square foot Peace and Healing
Garden will be constructed on 9th Street Park.

  • Location: Next to 1050 9th Street on 9th Street Park
  • Estimated Budget: $500K
  • Funding Source: Auraria Campus, CU Denver, CCD, MSU Denver, contributions via the community benefits agreement with the Ball Arena re-development, as well as community support.
  • Anticipated Timeframe: April 2026 – November 2026

Summit House – MSU Denver Housing

MSU Denver is constructing a 12-story student housing building. The building will include a floor dedicated to the Classroom to Career Hub (C2 Hub), which, in collaboration with Community College of Denver, connects students with career opportunities and industry partners. The ground floor will house multiple food and beverage options for students, faculty, staff, and community members.

  • Location: Lot East of the Tivoli Garage
  • Estimated Budget: $115 million
  • Funding Source: Student housing revenue as well as state allocations and philanthropic contributions
  • Anticipated Timeframe: June 2025 – March 2027

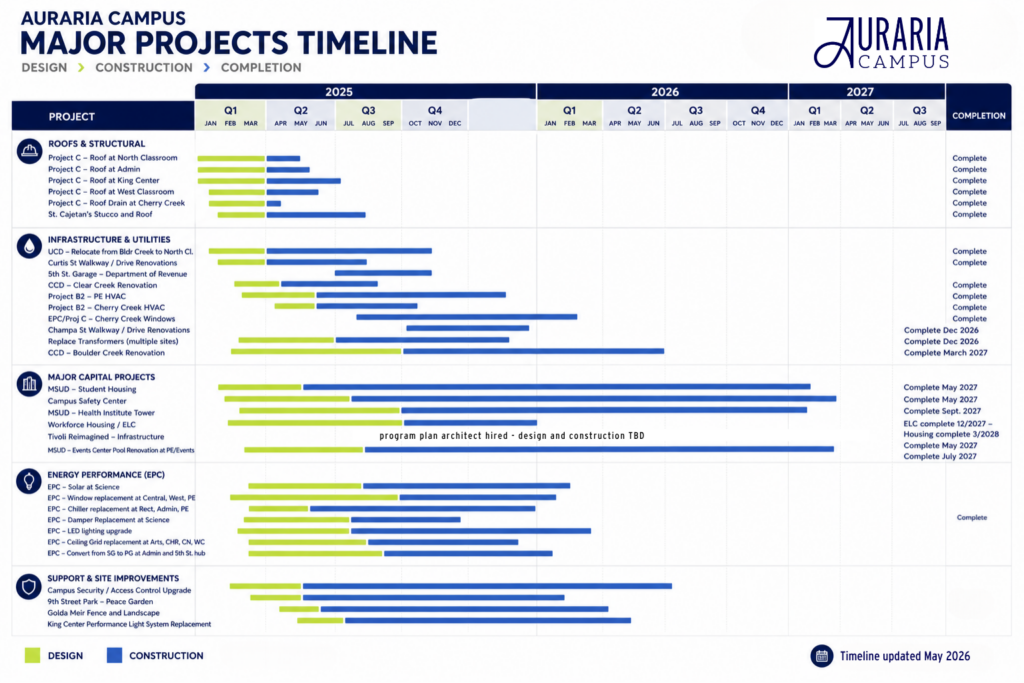

Completed Projects

5th Street Garage Department of Revenue Renovation

Since the 5th street garage was built in 2014 there has been an empty storefront space. The Department of Revenue will be renovating and leasing this space beginning in the fall to operate a Regional Service Center. The center will house:

  • DMV -Drivers License services
  • TAX-Taxpayer services
  • Lottery Claims office
  • Cashier and Tax remittance office

  • Location: 5th Street Garage
  • Estimated Budget: N/A
  • Funding Source: Department of Revenue and State of Colorado funding
  • Anticipated Timeframe: Complete!

Cherry Creek – Project B

Replacing Air Handling Units and the HVAC system in Cherry Creek

  • Location: Cherry Creek Building
  • Estimated Budget: $5 million
  • Funding Source: State of Colorado Capital Renewal project
  • Anticipated Timeframe: Complete!

Curtis & Champa Streets Walkway Improvements

Update walkways and emergency drive lanes to meet updated ADA compliance requirements. Update landscaping and add seating to improve outdoor environment on campus.

  • Location: Curtis & Champa Streets between 10th and 11th
  • Estimated Budget: $1.7 Million
  • Funding Source: State of Colorado Controlled Maintenance funded project
  • Timeframe: Complete!

EPC – Solar Panels on Science Building

This project will add 560 solar panels to the roof of the Science Building. These solar panels will double the number of solar panels on campus and increase renewable sustainable energy generation on campus.

  • Location: Science Building
  • Estimated Budget: $1.2 million
  • Funding Source: Energy performance contract
  • Anticipated Timeframe: Complete!

Events Center – Project B

Replacing Air Handling Units and the HVAC system in the Events Center

  • Location: Events Center
  • Estimated Budget: $8 million
  • Funding Source: State of Colorado Capital Renewal project
  • Anticipated Timeframe: Complete!

lighting replacement – project c

The Auraria Campus is upgrading all interior and some exterior lights to LED in the locations listed below.

  • Locations: 7th St Classroom, 7th St Garage, Arts Building, Cherry Creek, Administration Building, Central Classroom, Facilities Annex, Facilities Management, King Center, Library and Media Center, North Classroom, PE/Event Center, Rectory, Science Building, South Chiller Plant, St. Cajetan Center, Tivoli Student Union, West Classroom
  • Estimated Budget: $7.6 million
  • Funding Source: Environmental Performance Contract and State Capital Renewal Funds
  • Anticipated Timeframe: Complete!

Window Replacement Project – Project c

Replace all or a portion of the original windows in each of the identified buildings with new energy-efficient windows to help improve comfort in offices and classrooms as well as meet the Auraria Campus Climate Action Plan goals.

  • Locations: Boulder Creek, PE/Events, West Classroom building, Central Classroom building, Cherry Creek
  • Estimated Budget: $10 million
  • Funding Source: State of Colorado Capital Renewal project (also part of the Energy Performance Contract project (EPC)
  • Anticipated Timeframe: Complete!
